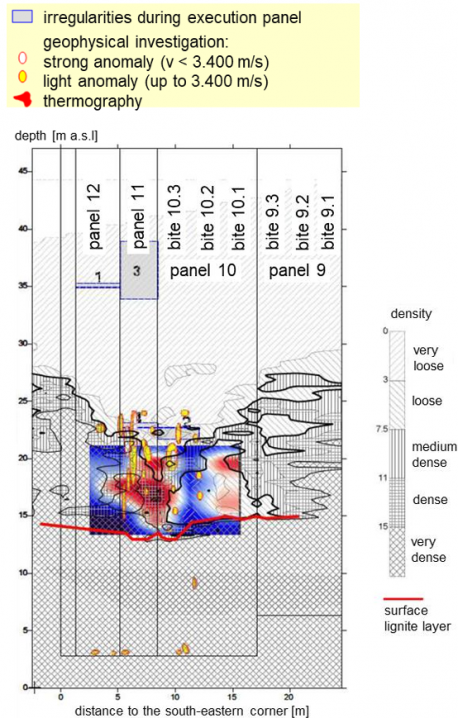

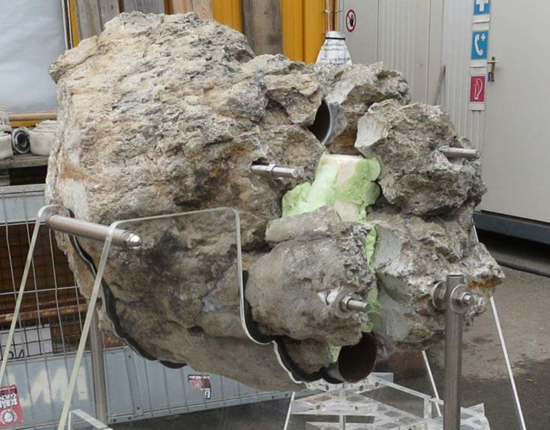

The void was ultimately traced to a construction oversight involving a large trachyte boulder encountered during excavation. When the boulder obstructed excavation of panel #10, it was partially displaced into the alignment of panel #11. To bypass the obstruction, the grab shell width was reduced from 3.4m to 2.8m, leaving a 0.6m-wide section unexcavated and subsequently filled with unconsolidated material. This unintentional gap, though limited in area, proved critical.
Further analysis confirmed no evidence of vertical soil ingress from the base, disproving earlier theories involving base failure or venting through the lignite layer. Instead, the collapse stemmed from execution-related error during diaphragm wall construction, exacerbated by limited field response to obstruction and absence of compensatory ground treatment like jet grouting.

The Cologne incident highlights the importance of implementing comprehensive quality control measures during deep excavation works, especially in urban environments with soft alluvial soils. It highlights several geotechnical and procedural lapses:
Defect Oversight: The 0.6m void, while narrow, allowed significant soil ingress due to high hydraulic gradients and loose granular fill.
Lack of Real-Time Correction: Despite recorded anomalies during excavation, no corrective action was undertaken before concrete pouring of panel #11.
Soil and Water Management: Over-pumping of groundwater beyond permitted limits likely contributed to soil destabilization, though not the primary cause.
Reinforcement Shortfalls: Investigations revealed missing reinforcement, with rebar reportedly sold as scrap on nearby sections. Though not directly linked to this panel, it suggests potential issues in site supervision practices.
Additionally, post-failure remediation efforts were described in technical reports as among the most complex undertaken for an excavation failure in Germany. These included underwater excavation supported by frozen ground techniques and installation of secant pile walls, all to enable access to the diaphragm wall joint for confirmation and sealing.
The collapse led to an out-of-court settlement in 2020, with the contractor joint venture agreeing to pay €600 million and reconstruct the damaged zone at their expense. Remedial works are projected to continue through 2033.
This case has been cited in technical literature as emphasizing the role of independent geotechnical review and execution monitoring. Regular communication between the client, designers, contractors, and external inspectors is indispensable for early detection and mitigation of excavation-related anomalies.
